New Forres Academy Development

Share New Forres Academy Development on Facebook Share New Forres Academy Development on X (formerly Twitter) Share New Forres Academy Development on Linkedin Email New Forres Academy Development link

New Forres Academy Construction Works

Construction works for the new Forres Academy development began on Monday 22 June 2026, following the completion of the mobilisation works.

Information about the planned construction works, timings, traffic management and access arrangements is provided below.

Structural Steelworks – 2 November to end of January 2027

Work on the new Forres Academy continues to progress, with the next stage of construction involving the installation of structural steelwork.

Structural steelwork is scheduled to take place from Monday 2 November 2026 until the end of January 2027, forming an important part of the framework for the new school building.

During these works, there will be an increase in construction traffic as steel and other materials are delivered to the site. Deliveries will be carefully managed and scheduled outside school drop-off and pick-up times to minimise disruption to pupils, parents and other road users.

Some additional noise is also expected and will be monitored and managed to ensure it remains within acceptable limits, with measures in place to minimise disruption to the surrounding community.

We appreciate the continued patience and understanding of the local community as work progresses on the new Forres Academy.

Drainage Works – Castle Street and Albert Street

As part of the new Forres Academy development, a new surface water drain is being installed between the new Forres Academy site and the Mosset Burn.

Phase 1 of the drainage works has now been completed. This included works around Orchard Road, Burdshaugh Road and Strathcona Road, with temporary traffic management and pedestrian diversions in place while the work was carried out.

Following our previous update on 15 September 2026, the next stages of the drainage works were again paused after further unexpected underground utility services were discovered.

Balfour Beatty has been working with utility companies and technical specialists to resolve the issue, and work is now due to restart.

The remaining works will be carried out in Phases 2, 3 and 4, with temporary traffic management, road closures and access restrictions in place at different stages.

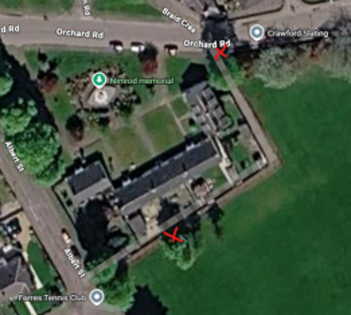

Updated site drawing showing planned drainage works

You can view an enlarged image showing the planned drainage works here.

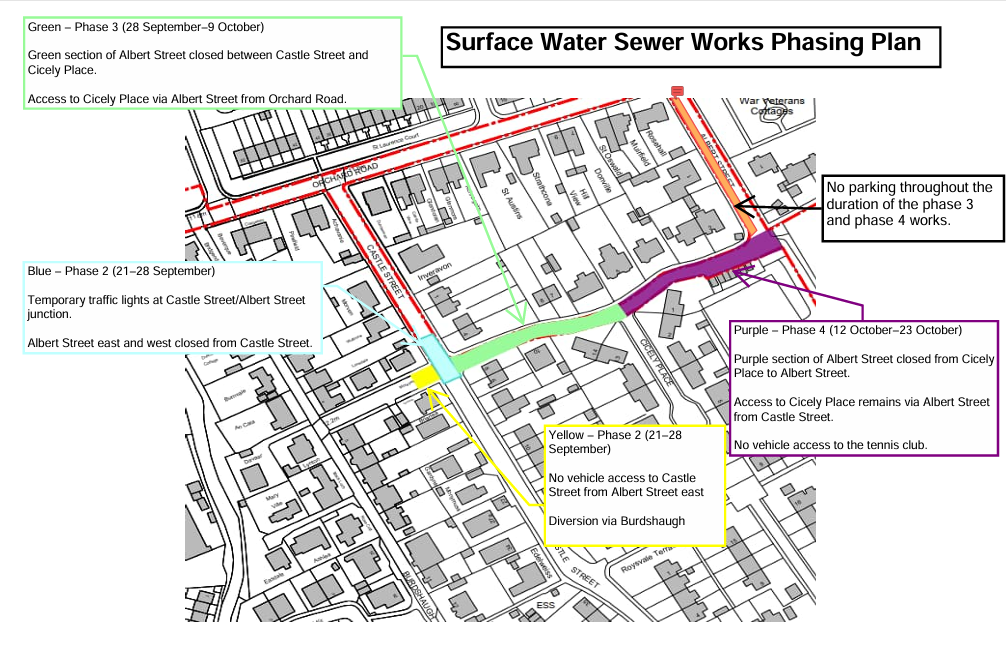

Phase 2 – Castle Street (Blue)

Work is expected to begin on 2 November 2026 and will last for up to 10 days.

This phase will take place around the junction of Albert Street and Castle Street, shown in blue on the map.

During this phase:

  • Temporary traffic lights will be in operation.
  • Vehicles will not be able to access Albert Street from Castle Street in either direction.
  • Diversion routes and traffic management signs will be clearly displayed.

Phase 3 – Albert Street (Green)

Work is expected to restart on 2 November 2026, alongside the Castle Street works, and will continue until around 20 November 2026.

During this phase:

  • The section of Albert Street shown in green on the map will be closed.
  • Access to individual driveways within the affected section will be restricted while works are taking place.
  • Access to Cicely Place will be via Albert Street from Orchard Road.

Phase 4 – Albert Street (Purple)

Work is expected to start on or around 23 November 2026, following completion of the Green phase of works, and will last for approximately two weeks.

During this phase:

  • The section of Albert Street shown in purple on the map will be closed.
  • Access to individual driveways within the affected section will be restricted while works are taking place.
  • Access to Cicely Place will be via Albert Street from Castle Street.
  • There will be no vehicle access to the tennis club during this phase.

Parking and access restrictions

During works along Albert Street, parking will not be permitted on the section of Albert Street shown in orange on the map.

There will also be no through route between Albert Street and Castle Street while these works are taking place. These access restrictions will remain in place until the work is completed.

Balfour Beatty will contact affected residents and property owners directly with more detailed information as the works progress. Support can be provided where required, including assistance with putting out bins and ensuring access for emergency vehicles.

New Bus Layby Entrance Works and Pedestrian Route Changes

Works to construct the new bus layby entrance off Burdsyard Road are now complete.

To allow construction activities to continue and the establishment of the contractor’s compound the existing footpath and cycleway adjacent to Sanquhar Road, shown in red on the map, is now closed and fenced off.

The new footpath on the west side of Roysvale Park, shown in blue on the map, provides an accessible connection between Burdsyard Road and the existing core path adjacent to Applegrove Primary School. Details of the path closure, diversion route and key dates are now displayed.

This route is expected to remain closed until completion of Phase 1 of the new Forres Academy development, currently anticipated in Autumn 2028, when it will reopen for public use.

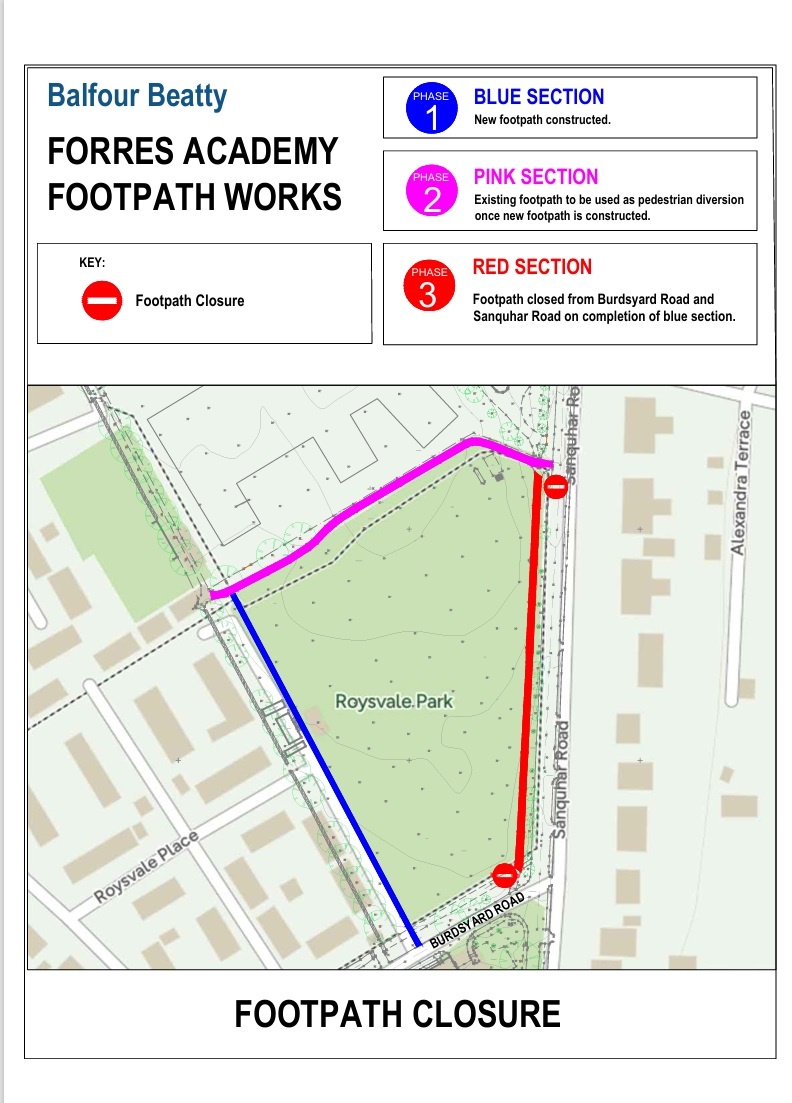

Site drawing showing new bus layby entrance works and pedestrian route changes

You can view an enlarged image showing the works here.

A printed copy, including full details and drawings of the planned mobilisation and construction works, is available for viewing at Forres Community Centre.

The safety of pupils, staff, residents and the wider community remain the priority throughout these works. Construction areas will be securely fenced at all times, with clear separation maintained between school operations and site activities.

Balfour Beatty and Moray Council are working closely to minimise disruption to residents and the wider community during this period. Should any issues or concerns arise during the works, residents can contact the Balfour Beatty team directly at ForresAcademyBB@balfourbeatty.com and a member of the project team will aim to assist where possible.

Further updates will be provided as the project progresses.
